Kitchen Remodeling · October 29, 2026 · 7 min read

How Long Does a Kitchen Remodel Take in Los Angeles? A Realistic Timeline

By the RAA Construction Group teamLicensed design-build contractor · CSLB #1047380

If you are planning a new kitchen, the first question is usually how long does a kitchen remodel take, and how long you will be cooking on a hot plate in the dining room. In Los Angeles, a typical full kitchen remodel takes about 3 to 6 months from the first design meeting to final inspection. Roughly 6 to 12 weeks of that is actual construction.

After 15+ years and more than 2,000 projects across the San Fernando Valley and Ventura County, we have learned that construction is rarely the slow part. The schedule is decided by design decisions, cabinet lead times, permits, and inspections. Below is the kitchen remodel timeline Los Angeles homeowners can actually plan around, plus the specific steps that keep it short.

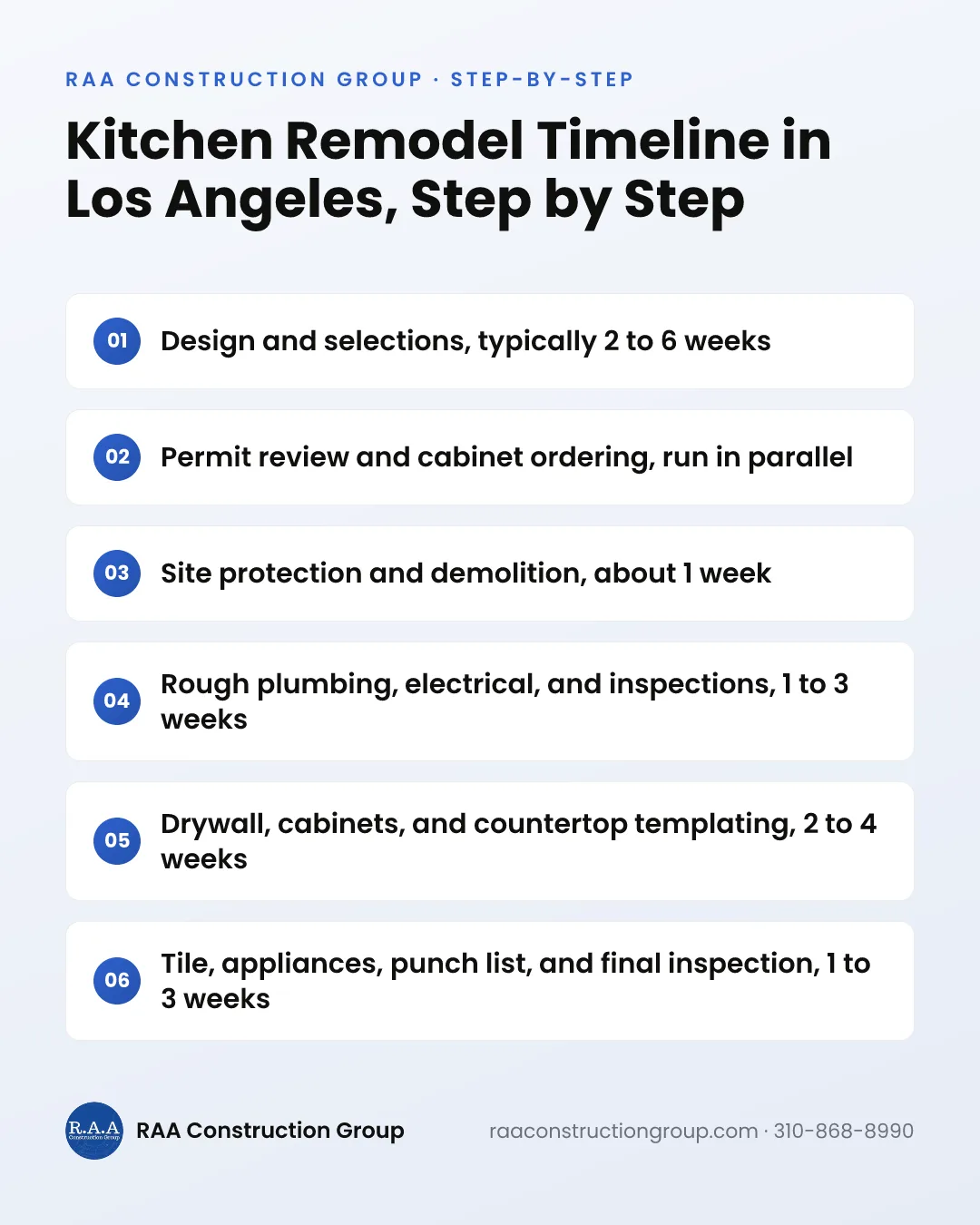

A six-step graphic showing the phases of a Los Angeles kitchen remodel from design and permits through demolition, rough-in, cabinets, and final inspection.
Typical Los Angeles-area phase durations; your schedule will vary with scope, site conditions, and permit review.

So, how long does a kitchen remodel take? Ranges by scope

The honest answer depends on how much you change. Moving walls, plumbing, or gas lines adds design time, permit review, and inspections. Keeping the same layout and swapping finishes is far faster.

Here are typical Los Angeles-area ranges from first meeting to final sign-off. They vary by scope and site, and none of them is a quote.

  • Cosmetic refresh (paint, hardware, counters, backsplash, no layout change): about 3 to 6 weeks total, often 1 to 3 weeks on site
  • Same-layout remodel with new cabinets and counters: about 2 to 4 months total, 5 to 8 weeks on site
  • Full remodel with layout changes, moved plumbing, or new lighting circuits: about 4 to 6 months total, 8 to 12 weeks on site
  • Remodel that removes a load-bearing wall or adds square footage: often 6 to 9 months, because engineering and longer plan check come first

Notice the gap between total time and time on site. Most of the calendar passes before the first cabinet comes off the wall, and that is where good planning pays off.

A week-by-week kitchen renovation schedule

Here is how a typical full remodel runs in our projects, assuming a permit is required and semi-custom cabinets are ordered. Some phases overlap on purpose.

  1. 1Weeks 1 to 4, design and selections: measure the space, finalize the layout with 3D renderings, and choose cabinets, counters, tile, fixtures, and appliances.
  2. 2Weeks 3 to 8, permits and ordering: submit plans for review while cabinets and long-lead items are ordered. Running these in parallel is the single biggest time saver.
  3. 3Construction week 1, protection and demolition: seal off the work area, protect floors, shut off utilities, and remove cabinets, counters, and flooring.
  4. 4Construction weeks 2 to 3, rough-in: framing changes, new plumbing and gas lines, electrical circuits, and recessed lighting go in, followed by rough inspections.
  5. 5Construction weeks 4 to 5, walls and floors: insulation, drywall, texture, primer, and flooring if it runs under the cabinets.
  6. 6Construction weeks 5 to 7, cabinets and countertops: cabinets are installed and leveled, then the fabricator templates the counters. Fabrication and install typically take 1 to 2 weeks after templating.
  7. 7Construction weeks 7 to 9, finishes: backsplash tile, sink and faucet hookups, appliance installation, lighting trim, and paint.
  8. 8Construction weeks 9 to 10, punch list and final: a walkthrough to catch small items, then final inspection and sign-off.

Smaller jobs compress this. A kitchen without moved plumbing or new circuits can go from demolition to cabinet installation in a few days.

Cabinet lead times: the biggest schedule driver

If your project slips, cabinets are the most likely reason. Cabinets must be installed before countertops can be templated, and countertops must be in before the sink, backsplash, and most appliances. One late delivery pushes everything behind it.

  • Stock or ready-to-assemble cabinets: often in stock or 1 to 3 weeks, with limited sizes and finishes
  • Semi-custom cabinets: typically 4 to 8 weeks from a signed order
  • Full custom or locally built cabinets: commonly 8 to 14 weeks, sometimes longer for specialty finishes or imported hardware

Those ranges start when the order is final, not when you first pick a door style. Shop drawings, finish samples, and sign-off can add another 1 to 3 weeks if decisions drag.

Order cabinets as soon as your layout is locked and dimensions are verified on site. Semi-custom and custom cabinets can then be built while your plans are in review, so they arrive close to the time demolition and rough-in wrap up.

Permits and inspections in Los Angeles

Most kitchen remodels that touch plumbing, gas, electrical, or walls need a permit. In the City of Los Angeles that means LADBS. Simpler work may qualify for a quicker over-the-counter permit, while layout changes or structural work go through plan check, which can take several weeks and may come back with corrections.

Pasadena, Thousand Oaks, Simi Valley, and Santa Clarita each have their own building department with its own review times, so ask early how long your city is currently taking. Plans also need to show Title 24 compliance, which in a kitchen usually means high-efficacy lighting, lighting controls, and proper range hood ventilation.

During construction, inspections set the pace. Rough plumbing, electrical, and framing must pass before drywall goes up, and the final inspection closes the permit. A failed item means a fix and a re-inspection, so careful rough-in work saves days. Our guide on when a remodel needs a permit in Los Angeles explains the same logic for bathrooms.

Where kitchen remodel delays really come from

Beyond cabinets and permits, these are the delays we see most often:

  • Hidden conditions: on Valley homes built in the 1950s and 60s we regularly find galvanized drain lines, ungrounded wiring, or old water damage once walls are open.
  • Electrical panel capacity: an induction range, extra circuits, and new lighting can require a panel upgrade, which may involve the utility and add weeks.
  • Change orders: moving an outlet after drywall or switching countertop material after templating restarts parts of the process.
  • Countertop slabs: a specific quartzite or marble slab may need to be sourced, held, and fabricated, which often takes longer than standard quartz.
  • Appliance backorders: a panel-ready refrigerator or specialty range can arrive late, and cabinets are often built around its exact dimensions.
  • HOA rules: some communities in Calabasas, Agoura Hills, and Thousand Oaks require review or contractor paperwork before work begins, and boards may meet only monthly.

How to shorten your kitchen remodel timeline

You cannot speed up a plan checker, but you can remove most of the delays you control.

  • Make every selection before demolition, including sink, faucet, hardware, tile, grout color, and lighting trims.
  • Get appliance spec sheets early so cabinets and electrical are sized correctly the first time.
  • Order cabinets and long-lead items while plans are in review, not after the permit is issued.
  • Keep the existing layout if it works. Leaving the sink and range in place can cut weeks of design, review, and rough-in.
  • Have appliances delivered and inspected before they are needed, and store them in the garage.
  • Hire one design-build team that handles drawings, permits, and construction, so nothing waits on a handoff.

On our kitchen remodeling projects, you get a fixed-price proposal and a written schedule before work begins, so you know when each phase starts and which decisions are due. If budget is your next question, see our breakdown of kitchen remodel costs in Woodland Hills.

Planning for life during construction

Expect your kitchen to be unusable from demolition until the sink and appliances are reconnected, which is most of the construction phase. Water may be shut off for short periods during rough plumbing, and dust barriers will close off nearby rooms.

Plan meals, school mornings, and any travel around the noisiest weeks, which are demolition and rough-in. If you are also considering a bathroom update, our bathroom remodeling team can often coordinate both projects in one schedule.

Set up a temporary kitchen before demolition day: refrigerator, microwave, coffee maker, and an induction hot plate in the dining room or garage. Families who do this stay far more comfortable through 6 to 12 weeks of construction.

Want a schedule built around your kitchen? Schedule a free on-site estimate and we will walk the space, review your goals, and outline a realistic timeline for your home in the San Fernando Valley or nearby.

Get a Realistic Timeline for Your Kitchen

Book a free on-site consultation and receive a fixed-price proposal with a written schedule. Call 310-868-8990 to get started.

Schedule a Free Estimate

FAQ

Kitchen Remodeling questions, answered.

How long does a kitchen remodel take in Los Angeles?
Most full kitchen remodels in Los Angeles take about 3 to 6 months from design to final inspection, with 6 to 12 weeks of actual construction. A cosmetic refresh can be done in a few weeks, while structural changes add time. Your timeline depends on scope, cabinet lead times, and permit review.
Can I live at home during a kitchen remodel?
Yes, most homeowners stay home. Expect no working kitchen for most of construction, dust and noise during work hours, and short water or power shutoffs. A temporary kitchen setup makes those weeks much easier.
Do I need a permit for a kitchen remodel?
If you are moving or adding plumbing, gas, electrical, or walls, you almost always need one. Cosmetic work like painting or replacing countertops in place often does not. Your contractor or the city's building department can confirm based on your exact scope.
How long does it take to get kitchen cabinets?
Typical cabinet lead times run about 1 to 3 weeks for stock, 4 to 8 weeks for semi-custom, and 8 to 14 weeks or more for custom. The clock starts when the order is final and drawings are approved. Ordering during plan check keeps cabinets from delaying construction.
What is the longest part of a kitchen remodel?
For most projects it is the time before construction: design, selections, permits, and cabinet production. On site, the cabinet and countertop phase usually takes longest because templating and fabrication must happen in order. Making decisions early shortens both.
